Grouting and ground engineering · railways · tunnels · dams · mines

We fix the ground under lines that cannot stop.

Settled track, wet tunnels, weak formation. We find the cause below, design the treatment and inject it inside the traffic block, with grouts and resins made at our own plant in Alwar.

Certified Konkan Railway, February 2026: settled slab track at T-46 P2 on the USBRL lifted back to its design profile on a live line, by up to 136 mm.

Long section of the T-46 P2 track repairSlab track between Tunnel T-46 and Bridge No. 239, lifted from its settled profile back to the design profile with PU injected under the slabs while trains kept running. The largest lift was 136 mm. LINE OPEN THROUGHOUT · NIGHT BLOCKS ONLY 136 mm 123456
  1. Note 1: Tunnel T-46, Portal 2. Track corrected by 12 to 48 mm inside the tunnel.
  2. Note 2: Ballastless slab track on embankment, on a 635 m radius curve with cant.
  3. Note 3: Settled profile after the 2025 monsoon (dashed), with highs and lows on each rail.
  4. Note 4: PuTeRA Level Up injected under the slabs, 15 to 20 mm of lift per cycle.
  5. Note 5: Saturated, soft formation with free water about 1 m below the surface.
  6. Note 6: Approach to Bridge No. 239.
Geo Constech
T-46 P2 · Sangaldan · USBRL
Client KRCL · Owner Northern Railway
2025–26 · Long section · Not to scale
136mm

Largest lift, on the most settled slab.

0mm

Residual settlement, measured after traffic resumed.

0

Traffic blocks beyond the planned night blocks.

T-46 P2, Sangaldan, USBRL. Read the case study

189km

Tunnels served and secured

110+

Projects successfully executed

34+

Field engineers

10+

Research papers and presentations

Start with the problem

What is happening on your site?

Pick the nearest one. You will see how we would treat it, and where we have done it before.

Choose one

Stop it at the source, from inside

We map the leaks, drill through the lining and inject a water-reactive PU that expands into the joints behind it, cutting the water off before it reaches the lining. The tunnel stays in use.

Done before

2,500 L/min

Seepage controlled in USBRL tunnels near Katra, recorded by Northern Railway in 2016.

See the project →

Lift it back to level, then fix the ground

PU injected under the slab lifts it in small steps inside the traffic block. Then the formation is grouted and the water cut off, so the next monsoon does not undo the work.

Done before

136 mm

Largest lift on T-46 P2, Sangaldan, with 0 mm residual settlement. Certified by KRCL.

See the project →

Fill it from below, without loading the support

Pipes or self-drilling anchors through the support carry high-foaming PU into the void. It fills from the bottom up, binds the loose material and cures light.

Done before

T-49B

Cavity treatment with PU in the USBRL escape tunnel at Arpinchala, for Afcons.

See the project →

Grout a canopy before you dig

A fan of perforated self-drilling anchors from the face, injected in stages, forms a grouted arch over the profile and consolidates the core. Excavate under it, then repeat with an overlap.

Done before

2 TBMs

Freed from loose, saturated sand 30 m below Delhi, after we sealed and consolidated the ground.

See the project →

Cut the seepage path

A grout curtain across the flow, and consolidation grouting under the base, with the grout chosen for the water: cement where the rock is open, resin where the water is moving.

Done before

Up to 85%

Seawater ingress into a micro-tunnel pit at Pipavav, cut by up to 85 per cent with grouting. Certified 2013.

See the project →

Pin it, drain it, catch what falls

Soil nails and self-drilling anchors, mesh or shotcrete on the face, drainage to take the water pressure out, and a barrier above the line.

Done before

52 days

Ahead of the contract date: slope restoration by PU and cement grouting on Western Railway’s Godhra–Ratlam section. Certified 2024.

See the project →

Consolidate the soil beneath it

Self-drilling anchors from outside the footprint and chemical grout consolidate the soil under the footings, while the building stays in use.

Done before

22×

Strength of treated site soil in IIT Patna’s tests for the Badi Patan Devi heritage site.

See the project →

Inject it from the dry side

Packers drilled to cross the crack inside the wall. PU or acrylate gel where water is moving; epoxy where the crack must be bonded.

Done before

Parsik

Seepage controlled through a century-old masonry arch, under live traffic, in Mumbai.

See the project →

One party, one accountability

We make the grout, and we put it in the ground.

Most firms in this field either sell chemicals they do not apply, or apply someone else’s chemicals to someone else’s design. We formulate and make our resins at Alwar, own the injection plant and send our own crews. If a result is not achieved, there is no argument about whose fault it is.

Our ISO certificates cover manufacturing and application together: polyurethane injection grouts, coatings, polyureas, epoxies and foams, with design and application.

Chemical supplierApplicatorGeo Constech
Makes the groutYesNoYes
Adjusts it to your ground and waterNoNoYes
Designs the injectionYesNoYes
Owns the injection plantNoNoYes
Sends its own trained crewsNoYesYes
Answers for the resultNoPartlyYes

Recent work

Proof from running lines, live tunnels and heritage sites

Railways · KRCL for Northern Railway · 2025–26

T-46 P2, Sangaldan, USBRL

Ballastless track that settled further every monsoon, lifted back to its design profile on a live line, with the ground beneath made stable.

136 mmlargest lift
0 mmresidual settlement
Feb 2026certified by KRCL

All projects and references →

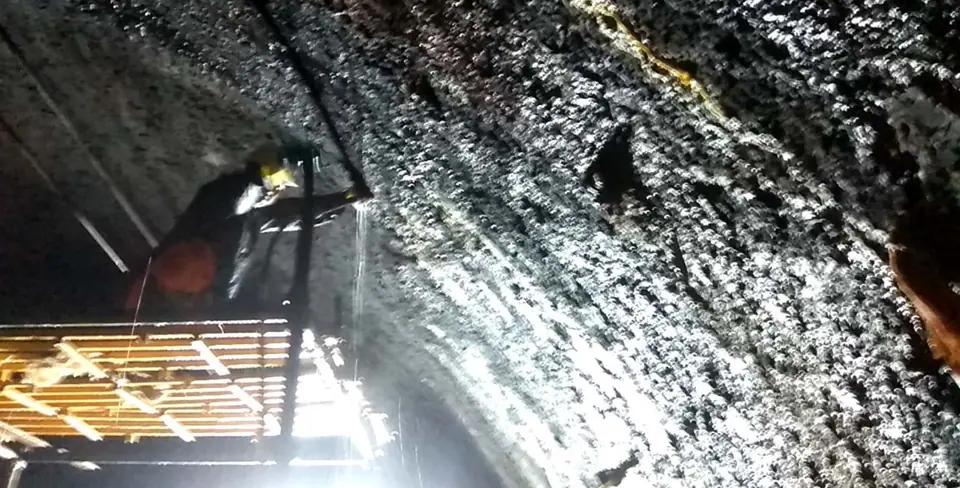

A grouting technician on a platform injecting resin into the arch of the Parsik tunnel
SiteInjecting the arch of the Parsik tunnel on the Thane–Kalyan main line, between trains. GCPL site photograph.

Where we work

Owners call us when the ground moves or water gets in.

Usually on a structure that has to stay in use while we work: a running line, an operating tunnel, a dam in service, a working mine.

How we work

Find the cause below, then treat it inside the block.

Lifting a slab without fixing the ground under it lasts until the next monsoon. So every job starts with the ground, and closes against a result agreed with you before work starts: a measured reduction in inflow, a target permeability, or levels held under traffic.

How we work, in full →

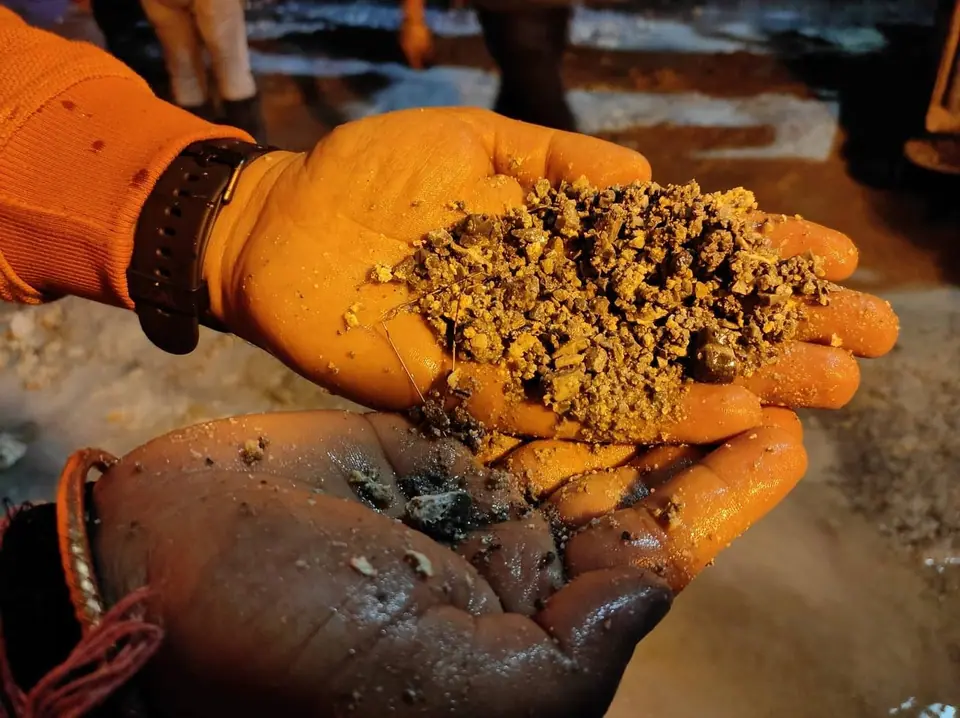

Two gloved hands holding a sample of granular ground on site
SiteChecking the ground on site. GCPL site photograph.
  1. Investigate

    Levels, leaks and inflow, with ERT, GPR or MASW to find the wet, soft or hollow ground.

  2. Design

    Holes, sequence, pressures and volumes in a method statement for the owner’s approval.

  3. Formulate

    The grout or resin, tuned at our plant to the ground, the water and the temperature on site.

  4. Inject

    Our pumps, our packers and our crews, with pressure and volume logged for every hole.

  5. Verify

    The result measured against the acceptance value, and the ground surveyed again.

Services

What we do in the ground

Tunnel water ingress control

Leaks and inflow stopped in tunnels, shafts and underground structures.

Pre- and post-excavation grouting

Water cut off and weak ground consolidated ahead of the face; voids closed behind it.

Cavity and void filling

Voids above tunnel crowns, behind linings and under slabs filled without loading the support.

Tunnel rehabilitation

Old and operating tunnels: seepage stopped, ground consolidated and lining repaired, under traffic.

Track and slab re-levelling

Settled ballastless track and slabs lifted back to level by PU injection, on live lines.

Permeation and chemical grouting

Weak, loose or wet ground strengthened and sealed by resins and gels that fill it without moving it.

TAM grouting

Staged grouting through sleeve pipes for shafts, foundations and deep excavations.

Curtain and consolidation grouting

Seepage cut-offs and foundation consolidation for dams, barrages, shafts and structures.

Rock bolting and self-drilling anchors

Rock bolts, self-drilling and prestressed anchors for tunnels, portals, slopes and caverns.

Slope stabilisation

Soil nails, anchors, mesh, drainage and rockfall barriers for slopes above roads, railways and towns.

Crack and joint injection

Leaking cracks and joints sealed, and structural cracks bonded, in concrete and masonry.

Waterproofing and polyurea linings

PU membranes and polyurea linings for decks, tanks, tunnels and water structures.

Mine shaft and strata treatment

Water sealed in shafts and declines; weak roof and face strata consolidated with resins and bolts.

Ground investigation and monitoring

ERT, GPR and MASW surveys, boreholes, lab tests and instruments, before and after treatment.

We make the grouts we use: PuTeRA, DrucHyd 2C, DrucPietra, DrucStone, Teracryl, GeoFine, TeraSeal, GeoShield, Stroxi and Geothane. The range →

Quality, environment and safety

Certified systems, and clients who put it in writing

ISO 9001Quality management24EQMK48
ISO 14001Environmental management24EEMO50
ISO 45001Occupational health and safety24EOMG50

All three certificates valid to 13 March 2027.

“The agency has demonstrated high technical competency in executing precision sub-surface stabilization and track geometry restoration.”
Konkan Railway Corporation Limited, completion certificate for T-46 P2, February 2026
2,500L/min

Heavy seepage inside USBRL tunnels controlled by our grout design and application, as recorded by Northern Railway’s USBRL project office in a letter of 28 April 2016.

Who we have worked for

Owners and contractors

Names from work orders, certificates and purchase orders we hold on file. Some were for our full design and application; some for material we supplied.

Owners and public bodies

  • Konkan Railway Corporation (KRCL)
  • Northern Railway
  • Central Railway
  • IRCON International
  • SJVN Limited
  • Delhi Metro Rail Corporation
  • Government of Bihar

Contractors

  • Afcons Infrastructure
  • ABCI Infrastructures
  • CEC-CICI JV
  • ITD Cementation
  • L&T-AM JV
  • HCC-CPL JV
  • Shree Krishna Construction
  • Coastal Marine Construction & Engineering
  • Vensar Constructions
  • Max Infra

Contact

Request a site inspection

Tell us where the ground or the water is giving trouble. An engineer reviews it and replies with the next step.

OfficeLower Ground Floor, A-34, A Block, East of Kailash, New Delhi 110065
PlantAlwar, Rajasthan

Your request and any files go to our sales team at connect@geoconstech.com and are used only to reply to you. See the privacy notice.

CallWhatsAppSite inspection
